抗倍特干掛墻板施工工藝詳解
抗倍特干掛墻板是一種新型的墻面裝飾處理工藝,采用免漆裝飾板:抗倍特板跟配套龍骨(gu)結合制成,抗(kang)倍特板(ban)和普(pu)通的木(mu)工板(ban)材(cai)的性能差距(ju)還是非常大(da)的在施工中一些(xie)細節上的處理會有所不同(tong),需要特別注(zhu)意(yi),那么就格林雅(ya)抗(kang)倍特板(ban)廠家一起來看(kan)一下抗(kang)倍特干掛墻板(ban)的施工工藝方法;

抗倍特板掛墻施工工藝
1、抗倍特板由于硬度較大,板材加工需要在工廠加工,即事先根據排版圖,繪制詳細的板材加工圖,再根據加工圖在工廠進行精確切割加工,一般的木工工具無法加工,須采用專業的工具;

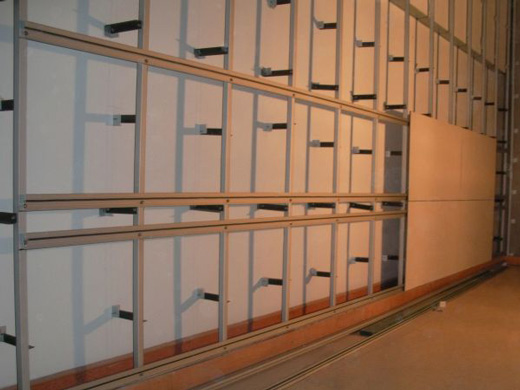

2、采用輕(qing)鋼結構作為(wei)抗倍特板的骨(gu)(gu)(gu)(gu)(gu)架,其骨(gu)(gu)(gu)(gu)(gu)架構成(cheng)為(wei):橫龍(long)骨(gu)(gu)(gu)(gu)(gu)為(wei)L56×3mm的鋁(lv)合金U型(xing)龍(long)骨(gu)(gu)(gu)(gu)(gu),間(jian)距(ju)不大(da)于500mm,接頭設在主龍(long)骨(gu)(gu)(gu)(gu)(gu)上(shang),通過螺栓(shuan)及轉(zhuan)接件與(yu)豎(shu)向主龍(long)骨(gu)(gu)(gu)(gu)(gu)連接;主龍(long)骨(gu)(gu)(gu)(gu)(gu)為(wei)□40×20×2mm鍍鋅方鋼管(guan)或鋁(lv)方管(guan),間(jian)距(ju)不大(da)于600mm,通過2個L50掛片干掛康貝特板;
3、抗倍掛墻板施工方案設計(ji),考慮(lv)到抗(kang)倍特板在(zai)溫差的影響下產生(sheng)的變形(xing)應力較大(da),決定抗(kang)倍特板安裝采用(yong)(yong)干(gan)掛方式(shi)。即采用(yong)(yong)U形(xing)掛件掛于橫龍骨上,在(zai)豎直方向采用(yong)(yong)企口方式(shi)留置4mm縫隙,滿(man)足其水平(ping)方向膨(peng)脹(zhang)系數(shu)的需要。
抗倍特掛墻主要施工方法及措施

1、工(gong)(gong)藝(yi)流程測量(liang)放(fang)線、出實際測量(liang)圖→排版→板(ban)材加工(gong)(gong)→主龍(long)(long)骨安裝(zhuang)→副(fu)龍(long)(long)骨安裝(zhuang)→定位打孔、固定掛件→飾面板(ban)安裝(zhuang)→竣工(gong)(gong)清理(li);現場(chang)安裝(zhuang)龍(long)(long)骨和后臺板(ban)材生(sheng)產可同時進行,能節省(sheng)工(gong)(gong)期;
2、測(ce)量放線、出(chu)實(shi)際測(ce)量圖進口板(ban)材(cai)為(wei)國外(wai)廠家(jia)定尺(chi)產品(pin),而且(qie)受加工(gong)(gong)機具和(he)精度(du)的要求,只能在(zai)工(gong)(gong)廠加工(gong)(gong)成型,現(xian)場不具備加工(gong)(gong)條(tiao)件(jian)。受磚(zhuan)縫影響(xiang),現(xian)場安(an)裝調整量在(zai)2mm以內,因(yin)此要求嚴格(ge)測(ce)量出(chu)建(jian)筑物的實(shi)際尺(chi)寸(cun)。除測(ce)量建(jian)筑物的幾個大角外(wai),所有門窗尺(chi)寸(cun)、位置都應予(yu)以實(shi)測(ce),套(tao)方找正(zheng),并根據測(ce)量結果繪制實(shi)際測(ce)量圖,并以此作為(wei)排版(ban)的前(qian)提(ti)。如果有必要,窗洞口位置還須根據排版(ban)要求作微量調整。還要考慮與(yu)其(qi)他區(qu)域(yu)不同材(cai)料交圈的具體(ti)情況,實(shi)際測(ce)量結果給后續工(gong)(gong)作帶(dai)來(lai)很大便利;
3、排(pai)版受磚縫和(he)板材(cai)(cai)定尺的影響,使用計算機和(he)CAD軟件進行排(pai)版,經過(guo)反復優化,考慮板材(cai)(cai)最大利用率,在取(qu)得(de)最終(zhong)排(pai)版方案后,針對每(mei)一塊板材(cai)(cai)細化加(jia)工(gong)圖(tu)(tu)及(ji)相應的開槽圖(tu)(tu)及(ji)板材(cai)(cai)四周(zhou)的企口加(jia)工(gong)圖(tu)(tu),一一編號(hao),作為加(jia)工(gong)依據(ju);
4、板材加工(gong)(gong)(gong)根據加工(gong)(gong)(gong)圖,所有板材均要求(qiu)使用數(shu)控平板切割刨槽(cao)機進行加工(gong)(gong)(gong),精度誤差要求(qiu)在0•5mm以(yi)內,以(yi)確保安裝精度;
5、龍(long)(long)骨制作安(an)裝(zhuang)所有(you)龍(long)(long)骨均進行熱鍍(du)鋅(xin)處(chu)理,焊(han)縫(feng)涂刷防(fang)腐漆,焊(han)接(jie)材料(liao)必(bi)須符合國家標準。龍(long)(long)骨安(an)裝(zhuang)后,必(bi)須進行反復檢(jian)查(cha)校正,對于(yu)橫龍(long)(long)骨可采(cai)用經緯儀作通長檢(jian)查(cha)。
6、定位(wei)打孔、固定掛(gua)件(jian)板材(cai)加(jia)工完成(cheng)后,按(an)(an)加(jia)工圖一(yi)一(yi)核實(shi),檢(jian)查無誤后按(an)(an)設計(ji)位(wei)置對板材(cai)背部(bu)的掛(gua)件(jian)進行定位(wei),并(bing)按(an)(an)要求打孔,安裝掛(gua)件(jian),要求定位(wei)誤差控(kong)制在(zai)±0•5mm,并(bing)逐一(yi)檢(jian)查牢固性。打孔必須對電(dian)鉆(zhan)加(jia)限位(wei)裝置,防止鉆(zhan)深(shen)。
7、板(ban)材安(an)裝(zhuang)安(an)裝(zhuang)順序原則上(shang)是自(zi)下而上(shang)、自(zi)邊(bian)而內(nei)安(an)裝(zhuang),最(zui)后窗臺收口。安(an)裝(zhuang)時(shi)注(zhu)意及時(shi)將插片(pian)插入豎向槽內(nei),同時(shi)注(zhu)意企口朝向是否(fou)正(zheng)確。每安(an)裝(zhuang)鋪設1排墻板(ban)后,應檢查一次垂直度(du)和平整(zheng)度(du),調整(zheng)板(ban)縫寬度(du),以便及時(shi)消除安(an)裝(zhuang)誤差;飾(shi)面板(ban)安(an)裝(zhuang)完畢后,也(ye)可用(yong)硅酮膠、收口條處(chu)理(li)企口4mm黑縫隙(看設計風格而定,一般也(ye)不用(yong)處(chu)理(li)),要(yao)注(zhu)意在易于被(bei)污(wu)染的(de)部位用(yong)塑料薄膜覆蓋保(bao)護。
8、竣(jun)工(gong)清理在全部工(gong)序完成后進行(xing)(xing)檢查(cha)驗(yan)收(shou),驗(yan)收(shou)合(he)格后然后統一撕去(qu)板材的(de)保護膜,對于板材的(de)局部污染,可采用中(zhong)性(xing)清洗劑進行(xing)(xing)清理。
好了關于“抗倍(bei)(bei)(bei)特(te)干(gan)掛墻板(ban)施工工藝”就(jiu)介紹(shao)到這里了,有質(zhi)(zhi)量保證的抗倍(bei)(bei)(bei)特(te)板(ban)裝(zhuang)飾性很(hen)好,這毋(wu)庸置(zhi)疑,不過(guo)現在(zai)抗倍(bei)(bei)(bei)特(te)板(ban)材市場質(zhi)(zhi)量參差不齊,還(huan)出(chu)現了好多用所謂的“二代抗倍(bei)(bei)(bei)特(te)”表面貼防(fang)火板(ban)冒充抗倍(bei)(bei)(bei)特(te)板(ban)的情況,很(hen)多人都上當,所以大家一定要認真辨別;
